One missing document or a small mistake can delay your DCD approval for weeks — or even lead to rejection.
The Dubai Civil Defense approval process is strict, and many projects get stuck in reviews and inspections simply because they miss key steps.
This guide covers:
✓ Requirements ✓ Required documents ✓ Timeline ✓ Fees
Skip the costly comments. Read on to master the DCD checklist and secure your approval from the very first submission.
☑ DCD Approval Process in Dubai (Quick Overview):
Before diving into the full process, here’s a simplified breakdown of how DCD approval works in Dubai:
- Purpose: Ensure full compliance with the UAE Fire & Life Safety Code.
- Key Requirement: Approved fire alarm & firefighting system drawings.
- Submission Method: Through the official DCD Smart Portal (via approved contractor).
- Final Outcome: DCD Completion Certificate (required for operation & licensing).
⏱ Typical Timeline: 7–30 working days.
💸 Estimated Cost: 3,000 – 20,000 AED (depending on project size).
Below, we break down each step in detail to help you avoid delays and approval rejections.
Contact Us Now!
Your Project, Our Priority: Fast & Reliable Approvals
Table of Contents

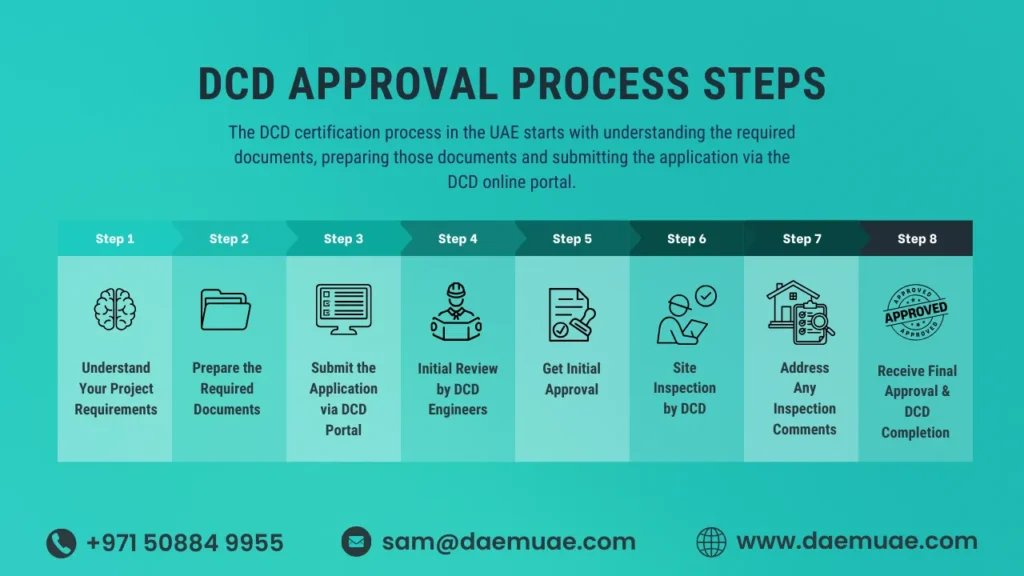

Step-by-Step DCD Approval Process in Dubai
the Dubai Civil Defense (DCD) approval process is a structured procedure that includes preparing compliant documents such as fire alarm system layouts, submitting them through the DCD portal, passing technical reviews, and completing a final site inspection.
Here is a step-by-step guide to the DCD approvals submission process:
- Step 1: Understand your project requirements.
- Step 2: Prepare the Documents.
- Step 3: Submit via DCD Portal.
- Step 4: Initial Review by DCD Engineers.
- Step 5: Site Inspection by DCD.
- Step 6: Address Inspection Comments.
- Step 7: Receive Final DCD Approval.
1- Understand Your Project Requirements
The DCD approval process begins with a clear definition of the project, such as its type (industrial, commercial, or residential), its scope (area and occupancy density), and the type of activity (restaurant – mall).
Project Requirements that determine the required documentation, such as the suppression system plan and the required fire safety solutions (e.g., strategic distribution of emergency exits).
Here is how understanding your project requirements impacts the civil defence approval Dubai:
- Project Type: Determines the hazard level and the required fire safety standards, including emergency exits and access routes.
- Project Scope: Includes building size, number of floors, and occupancy load, which define the scale of fire protection systems such as sprinklers and alarms.
- Project Activity: Specific use cases (e.g., restaurants or malls) require specialized fire safety solutions and approvals.
Zero Delays, Maximum Safety Compliance Protection
Upgrade to professional fire alarm system services and ensure your project meets every Dubai Civil Defense standard without the stress.
2- Prepare the Required Documents
All required DCD approval documents must comply with Dubai Civil Defense regulations and align with the UAE Fire and Life Safety Code, including properly designed fire alarm layouts, fire protection system drawings, and complete project documentation, like Architectural Design Layouts.
You must also adhere to the filing standards specified by Dubai Civil Defence (DCD), such as the correct format (PDF).
Key DCD document requirements:
- Engineering Drawings: All engineering documents must comply with the dcd fire code (including the submission of site and floor plans).
- Format: Drawings must typically be submitted in PDF or DWF formats.
- Maximum Size: Individual drawing files usually have a maximum size limit (commonly 50MB), and if exceeded, the file must be split and clearly named.
- Total Submission Size: The cumulative size of the entire submission often has an upper limit (up to 500MB).
3- Submit the Application via DCD Portal
Once your DCD approval Dubai documents are prepared, the next step is to submit your application through the Dubai Civil Defence portal.
This is the official platform where all DCD approval requests are processed, reviewed, and tracked.
How to submit your application through the DCD portal:
For New Users:
Create an account by registering on the Dubai Civil Defense e-services portal.
Enter your Emirates ID and activate the account via an OTP sent to your phone.
Complete the profile details, such as selecting a username and password.
For Registered Users:
Log in using existing account credentials (username and password).
Directly access dubai civil defence website services without re-registering.
Once registration is complete, the documents are uploaded via the portal, and the Civil Defense team begins the technical review of the application.
Stop Waiting Start Building.
Trust proven authority approval services in Dubai and Sharjah to keep your project moving without costly setbacks.
4- Initial Review by DCD Engineers
Once the files are uploaded via the dcd portal dubai, the technical audit phase by Civil Defense engineers begins. They meticulously review engineering plans, such as the fire alarm system layout, to ensure compliance with fire safety standards, such as the correct spacing of fire detectors (a maximum distance of approximately 9 meters between smoke detectors).
The following elements are audited by engineers during the dcd dubai review:
1- UAE Fire and Life Safety Code of Practice: The main reference for all building requirements in the state.
2- International Standards: Such as NFPA and British Standards for cases requiring specific technical details, like high-hazard warehouses that require specialized sprinklers such as ESFR.
3- Civil Defense Operational Regulations: These include auditing:
Escape Routes: Adequacy of emergency exits (at least two separate exits for any floor accommodating 50+ people) and corridor widths (minimum 112 cm).
Active Protection Systems: Distribution of sprinklers, smoke detectors, and alarm panels.
Passive Protection Systems: Fire walls and fire-rated doors to ensure fire containment.
Ventilation Systems: Efficiency of smoke extraction fans to ensure clear visibility during evacuation.
Fire Partitioning: Separating hazardous areas (such as generator rooms and kitchens) with fire-resistant walls for at least two hours.
Why risk your DM Approval Building Permit on a rejected DCD NOC?
At DAEM engineering consultants, we bridge the gap between engineering and safety to ensure neither one fails.
5- Site Inspection by DCD
The dcd inspection of the construction site is considered the final test for fire-fighting systems.
A DCD-approved contractor submits a technical inspection request upon the completion of construction works (such as the installation of false ceilings).
The civil defence inspection officer conducts a meticulous examination of the fire alarm system components, such as notification devices, and the fire suppression system (such as pump pressure), compared to your approved plans.
The documents required for the DCD site inspection include:
DCD DRAWING APPROVAL (drawings stamped by the Civil Defense Department).
A preliminary copy of the DCD NOC to ensure the project matches the initial approval.
DCD certificates of conformity for every installed component (pumps, detectors, sprinklers, cables).
Testing reports (pump test, alarm test, etc.) signed by an authorized consultant.
Maintenance manuals or as-built drawings (for large projects).
dcd approved amc contract (Annual Maintenance Contract) with a fire systems maintenance company certified by Civil Defense, such as DAEM company.
Ready to secure your compliance?
Avoid delays with our expert tips for successful Dubai civil defense inspection.
6- Address Any Inspection Comments
If the dcd dubai inspector identifies any gaps during the technical audit of the project site, a technical observation report will be issued.
This report highlights incomplete works, such as a lack of illuminated exit signs, or equipment that does not comply with approved standards, such as the use of non-fire-rated finishing materials.
The following are the steps to handle a DCD observation report:
Receipt of the Comprehensive Report: The inspector accurately identifies the deficiencies (e.g., insufficient smoke detectors, inadequate pump pressure, or unclear directional signage).
Execution of Rectifications: The owner or the approved contractor must perform the required technical modifications accurately to match the code.
Requesting a Re-inspection: Once ready, a new request is submitted via the portal to schedule a second visit to ensure all points have been addressed and secure the civil defense permit.
💡 Working with experienced DCD approved fire consultants helps ensure that all systems are installed according to approved drawings and inspection standards.
7- Receive Final Approval & DCD Completion Certificate
After the inspection process is completed and full compliance is verified, the Dubai Civil Defence issues the final DCD certificate, confirming that the building meets all required safety standards before operation.
This fire safety certificate serves as an official approval document that ensures the safety of the building and its occupants, and it can be obtained electronically through the Civil Defense website.
📌 Remember: Approval is not the final step. To maintain compliance and avoid future violations, regular fire safety system maintenance is required to ensure that all systems remain fully operational and aligned with DCD regulations.
Dubai Civil Defence (DCD) approval process Approval Process by Project Type
The steps for obtaining Dubai Civil Defense approval are unified across all projects, whether commercial or residential, starting from the submission of drawings through to the final inspection and issuance of the certificate.
However, technical evaluation criteria and dcd inspection points vary according to the building’s hazard classification (low – ordinary – high) and the type of activity (commercial, industrial, service, or residential), as the code mandates specific preventive requirements for each sector to ensure the safety of lives and property.
1- DCD Approval Process for Hotels & Hospitality
The Dubai Hotel DCD Approval follows the same basic approval steps (starting from plan submission to the compliance certificate), but it includes additional requirements during the review phase due to their classification as high-occupancy hazard facilities.
This includes verifying advanced alarm systems such as voice evacuation systems, and ensuring system interfacing with elevators and control systems to guarantee an automated response during emergencies, in addition to reviewing the distribution of exit routes to suit full occupancy scenarios.
2- Dubai Civil Defence approval process for restaurants
The DCD Approval Process for Restaurants follows a technical path primarily focused on kitchen hazards (grease and oil fires) and gas installations.
In restaurants, dcd inspectors scrutinize the layout of cooking equipment such as fryers and grills to ensure full coverage within the automatic fire suppression system (Ansul System), in addition to verifying the system’s connection to a valve that automatically shuts off the gas supply upon fire detection.
3- DCD (Dubai Civil Defence) approvals process for educational institutions
The DCD approval for Educational institutions, such as universities and schools, rely on securing “life safety” and ensuring ease of evacuation for students and people of determination.
Intense scrutiny is placed on the clarity of escape routes, along with the provision of clear evacuation plans showing the shortest path to exits and approved assembly points.
4- DCD approvals for transportation facilities in Dubai
The DCD approvals for transportation facilities require complex engineering solutions due to the vast open spaces (such as airports) or the presence of underground tracks (such as metro stations). The primary focus is placed on smoke management (directing smoke away from escape routes) and voice evacuation systems in multiple languages (Arabic-English).
5- Dubai Civil Defence (DCD) approval process for public buildings
The dcd approval process for public buildings, such as malls and government facilities, focus on the efficiency of central automatic sprinkler systems and securing vast shopping areas by auditing the hydraulic calculations of sprinkler networks to ensure effective coverage of open spaces. Additionally, they verify the distribution of hose reels to ensure rapid access from all points.
6- DCD Approval for Commercial Buildings in Dubai
Commercial building approvals rely on securing escape routes and preventing smoke migration between floors, while ensuring the safe egress of employees.
Inspections include Staircase Pressurization testing, installing additional Void Detectors in concealed spaces, and interfacing the BMS with the fire alarm to shut down HVAC units during emergencies.
7- DCD Approval Process for Industrial Facilities
The dcd approval process for industrial facilities (such as desalination plants) is based on evaluating the nature of stored materials and their hazard levels, which determine the required fire suppression systems (such as automatic sprinklers or specialized systems like foam).
It also involves compartmentalization to minimize fire spread between warehouses, making the review process more complex compared to commercial or entertainment buildings.
8- DCD approval for healthcare facilities in Dubai
DCD Approvals for healthcare facilities focus on the Defend in Place principle due to the difficulty of vertical patient evacuation.
DCD inspections include dividing the building into two-hour fire-rated compartments, testing medical gas systems, and ensuring the continuity of life safety systems during power outages.
How long does it take to get civil defence approval dubai?
The process of obtaining Dubai Civil Defense approval typically takes between 7 and 30 working days, depending on the project’s complexity and the accuracy of the submitted documentation.
Simple projects, such as offices, are completed at a faster pace (7 – 10 working days), while large-scale projects like hospitals may require more time (15 – 30 working days) to ensure a comprehensive review of all safety systems and field inspections.
Here are the timeline details for a Civil Defense (DCD) NOC:
Initial Approval: Usually issued within a short period ranging from 24 hours to 3 working days, serving as the first step to commence any legal project procedures.
Final Approval (Inspection): Takes an average of 14 days; however, in cases of major projects like hotels, site inspection processes may extend to 30 days to ensure full system compliance.
Contact Us Now!
Your Project, Our Priority: Fast & Reliable Approvals
How much do Civil Defense (DCD) approval fees cost?
Civil Defense (DCD) NOC PROCESS in Dubai typically range from AED 3,000 to AED 20,000 (approximately $817 – $5,446). The final cost depends on the project’s area, type, and complexity.
Here is a breakdown of the primary fee structure for the Dubai Civil Defense approval process:
| Service Type / Procedure | Estimated Fee (AED) | Additional Notes |
| Drawing and Blueprint Approval | 0.5 – 1 per m² | Varies by activity type (Residential / Commercial) |
| Fire Systems Approval | 1,000 | Fixed fee per individual fire system |
| Modifications and Resubmissions | 1,000 | Applied for every new drawing review request |
| Field Inspection (Site Visit) | 500 – 1,000 | Fees paid for each site inspection visit |
| Completion Certificate (Safety) | 520 | Includes innovation fees (AED 20) |
| Engineer / Technician Card | 300 – 350 | AED 50 added for each additional approved system |
| Administrative Fees (Knowledge/Innovation) | 10 – 20 | Nominal fees applied to each electronic application |
Master the DCD Approval Process with Confidence!
Navigating the dcd approval process shouldn’t be a source of stress or unexpected costs. From the first life safety drawing to the final site inspection, every detail counts in securing your business’s future.
Don’t leave your investment to chance. By partnering with a certified expert like DAEM dcd approved fire consultants, you turn a complex regulatory hurdle into a seamless transition to operation.
Frequently Asked Questions:
1- What are mistakes to avoid when getting DCD approvals?
Mistakes to avoid when getting DCD approvals include submitting incomplete or non-compliant fire alarm and fire fighting drawings that do not align with the UAE Fire & Life Safety Code enforced by Dubai Civil Defence.
Common errors also include using non-approved contractors, failing to provide hydraulic calculations or equipment datasheets, and discrepancies between approved drawings and on-site execution.
2- What is a DCD permit in Dubai Customs?
A DCD permit in Dubai Customs refers to a fire safety clearance issued by Dubai Civil Defence for facilities operating under Dubai Customs jurisdiction.
It confirms that warehouses, logistics zones, or bonded facilities comply with UAE Fire & Life Safety Code requirements before operational approval.
3- Is a final certificate the same as a completion certificate?
No, a Final Certificate and a Completion Certificate are not always the same, although they are related.
A Completion Certificate confirms that construction works are finished as per approved drawings, while a Final Certificate from Dubai Civil Defence verifies that fire and life safety systems are fully tested, compliant, and operational.
4- What is the DCD fire code?
The UAE fire code is a set of regulations that ensure the safety of the buildings and the residents.
5- Which fire suppression systems are DCD-approved?
The Dubai Civil Defense (DCD) approves fire suppression systems that meet stringent safety and performance standards, including water-based sprinklers, gaseous suppression agents like FM-200 and Novec 1230, foam systems, and chemical-based solutions. All approved systems must comply with local regulations and international standards.
6- What types of fire suppression systems are used in Dubai across different sectors?
Dubai applies a wide range of fire suppression solutions depending on the facility. For example, Fire Suppression Systems for Oil Wells & Remote Storage are tailored for extreme industrial environments, while Restaurant Fire Suppression System units are designed to handle grease and cooking-related fires.
Similarly, Fire Suppression Systems for Mobile Stations and Fire Suppression Systems for Buildings ensure compliance across mobile and fixed infrastructures.
In addition, Fire Suppression System for Food Trucks in the UAE offers compact protection for mobile kitchens, Fire Suppression Systems for Commercial Kitchens provide advanced solutions for large-scale food operations, and Fire Suppression System for Home ensures safety in residential environments.
7- How can fit-out contractors avoid project delays with fast DCD inspections?
Fit-out contractors can avoid DCD delays by ensuring all fire alarm and fire fighting systems are installed exactly as per approved drawings and tested before inspection by Dubai Civil Defence.
Submitting complete documentation, such as as-built drawings, material approvals, and test reports, prevents inspection rejection.
9- Why Are Fire Alarm Systems Crucial for Buildings in the UAE?
Fire alarm systems are crucial in the UAE because they are mandatory under the UAE Fire & Life Safety Code enforced by Dubai Civil Defence.
They provide early detection and automatic notification to occupants and, when integrated with Hassantuk, to emergency response teams.
